The Big Event and its Ripple Effects

From Team '23

Tempo Team

The airline travel debacle that unfolded through late December affected millions of travelers, and recovering from it will materially impact at least one airline’s financial health. The unexpected but anticipatable weather events that impacted flight schedules triggered staffing challenges and ultimately caused thousands of cancellations. This was a classic example of an exaggerated ripple effect plaguing planners and project managers across all industries. It prompted me to think through how I have overcome the uncertainties represented in a foreseeable and adverse “Big Event” in the projects I have led. As we have now witnessed the significant downside when such events are not sufficiently considered, I will offer a path to plan for and mitigate the impact of downside risks that we all face.

In a previous blog post, I discussed the dangerous impact of discarding variation in task estimates and dependencies between other tasks or projects. The vast majority of Project Management tools use averages, thus ignoring variation for tasks and the dependencies between tasks, resources, and events. This ensures that a project or a collection of projects will be late. Combined with other factors, such as how we create priorities at the beginning of a project, the issue is not whether the project will miss a deadline but how many times we will have to adjust the deadlines. Your schedules will not be able to adapt to inevitable change, delays will stack up, and your project will be vulnerable to significant hindrances or even complete meltdowns.

The solution to this problem is using Portfolio Manager (formerly LiquidPlanner) , which handles both variation (through ranged estimation) and dependencies and flags projects that will be delivered late when preceding tasks are not completed on time.

Introducing the Big Event

In that blog, we took a simple set of projects and used the Latest Completion Date as their deadlines. We are using the new version of Portfolio Manager (formerly LiquidPlanner) below, so we are setting deadlines based on Target Finish based on the Latest Finish, as shown in Figure 1.

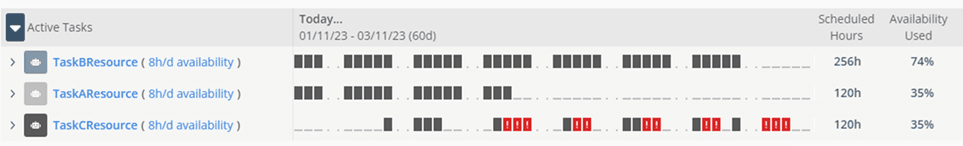

Figure 1 – The New Portfolio Manager (formerly LiquidPlanner) before the Big Event

“Special cause” variation usually results from some abnormal or unexpected event, such as a significant machine breakdown, weather event, a worker strike, a substantial order, etc. Sometimes it can be predicted, and we can plan our response before, during, and after the event. We know the plan will not be correct, but we have a “What If” tool to keep up with the changing conditions to make intelligent decisions. Accuracy and decision-making will improve as we move closer to the event. Most customers would instead be told the truth about the consequences of a “Big Event” after the fact and then kept in the dark or given entirely unrealistic promises.

This ripple effect is impossible to counter unless we take some action and plan for its occurrence beforehand. Since we are still determining when the event will occur and its duration, some organizations may use the “wait and see” approach. Expensive overtime and frustrated customers are often the results of this type of planning. Let’s look at the variation and dependency model and how we might look ahead and do “What Ifs.”

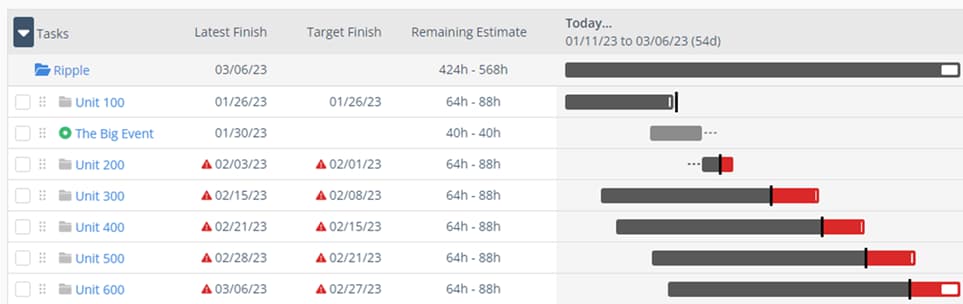

Figure 2 – new Portfolio Manager (formerly LiquidPlanner) with the Big Event Impact without countermeasures

Figure 2 shows the estimated impact of the Big Event without taking any countermeasures. It’s only one scenario based on current predictions. That does not provide an excuse not to do some essential emergency planning.

Recovering from the Big Event

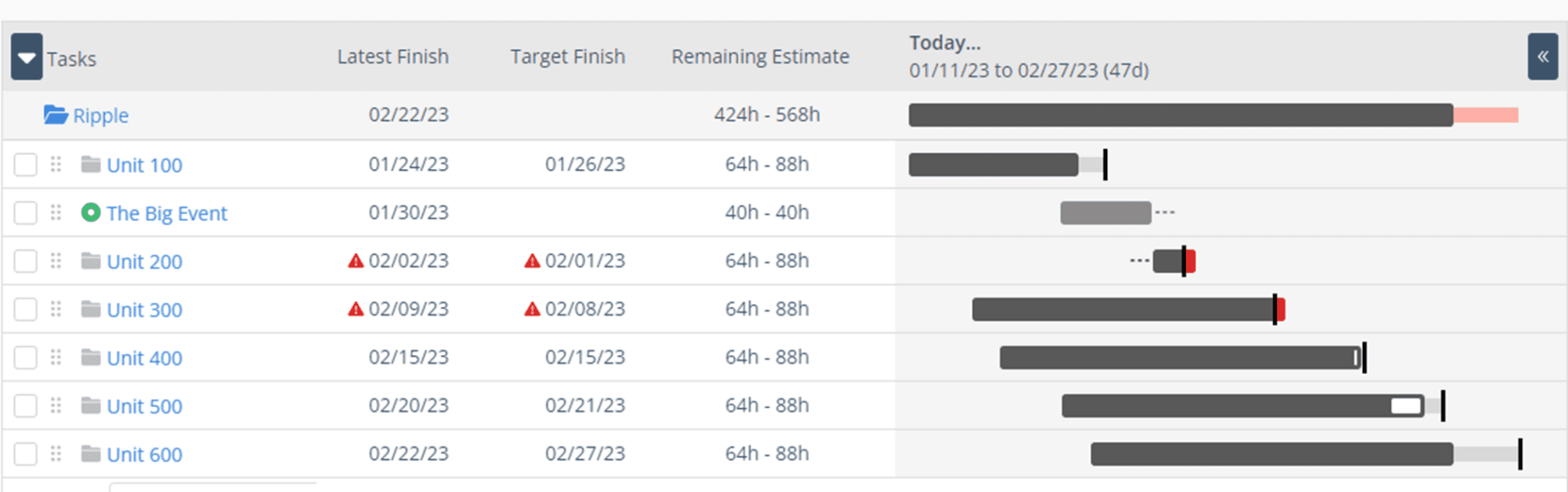

The Classic Version of Tempo allows you to leverage the power of Critical Chain Project Management, a method yet to be included in the new version of Tempo. It would show where the problem will appear ahead of time and allow us to draw conclusions on what countermeasures to take. In this case, however, we can use the new version to help us determine what to do. The reason is that the Units all have the same tasks and durations, meaning the busiest resource is the one that is causing the most delay and the one we must improve.

Figure 3 – Resource Workload

Resource B is clearly the busiest resource from the start of this start frame to the end, being scheduled for 254 hours and using 74% of its Availability. If we can get more out of this resource, we should recover quickly after the Big Event. It is time to run some “What If’s” to see if we add overtime on the weekends and during the week. We can also train A and C resources to do this work. The What Ifs are based on your particular situation.

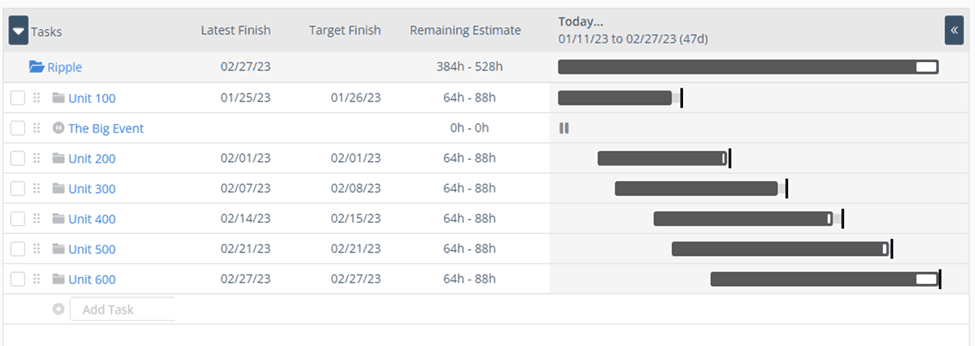

Figure 4 – Adding More Resource B Resource Hours

In our experiments, it becomes clear that no matter how many “What Ifs” we run, it’s clear that we cannot deliver on time for the Customers who have purchased Units 200, Unit 500, and Unit 600 look good if we continue the over time, but it seems like we can stop the extra hours for Resource B before then. Unit 400 will require our attention as the situation changes to ensure it arrives on time. You get the idea. We have a better chance of minimizing the damage if you are proactive instead of reactive. Figure 5 shows the results of one of the experiments.

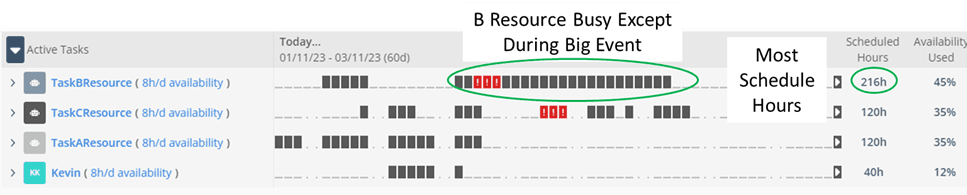

Figure 5 – Present Reactive Plan

Conclusion

We can’t prevent Big Events, nor control the type of events they are. It should be clear now that organizations need to have a plan for reacting to a Big Event and dealing with the constant variation. The need for these methods become more evident as Big Events become more predominant – weather, airline, supply chain, and manufacturing issues. Planning the reactions to these events improves communication and projects a sense of calm during a time of chaos. This brings the confidence needed to deal with turmoil and the understanding to deal with management requests for updates when certainty cannot be provided.

Call it self-defense for those dealing with Big Events, Big Management, and Big Voices!

About the Author

Kevin Kohls is the leading authority in using the Theory of Constraints in the Auto Industry. He used LiquidPlanner successfully for engineering to order at Rex Materials to increase OTP by more than 95%. Kevin is also the author of Addicted to Hopium a book about the process of throughput and breaking the habit of guesswork. He can be contacted at kevin.kohls@yahoo.com. View Kevin’s LinkedIn here.

Explore More Content

Get the data you need to succeed

Time Tracker

Extend your Jira with prebuilt and highly configurable reports for straightforward time tracking.

Learn more

Centralize real-time plans in one view

Integration: Structure and Gantt Charts

Gain a more complete project management solution, simplifying project reporting, improving collaboration, and ensuring projects stay on time and within budget.

Learn more

Jira Team & Resource Management

Capacity Planner

#1 Jira Resource Management App: Optimize team allocation, skillset utilization, capacity planning & project management

Go to marketplace

Strategic Portfolio Management

Strategic Portfolio Management

Modern modular PPM solutions that scale with your business. Align your teams with the integrated platform that bridges the gap between strategy and execution.

Learn more

AI-enabled capacity visualization

Capacity Insights - Open Beta

Deliver visibility into how your team's time and efforts align with business objectives and project ROI - without the manual effort

Learn more

Powered by Structure’s custom hierarchies, visualize your roadmap, project plans, timeline & dependencies within Jira Gantt charts

Go to marketplace

Take control of your projects

Integration: Portfolio Manager and Jira

Portfolio Manager integrates seamlessly with Jira to give you predictive scheduling, real-time scenario modeling, and advanced resource management – ensuring you stay on track, no matter what challenges arise.

Learn more

No-code Tableau Jira integration

Tableau Connector for Jira

Effortlessly bridge Jira with Tableau, unlocking unparalleled insights and enhancing decision-making

Learn more

Jira Time Tracking

Timesheets by Tempo

#1 Jira Time Tracking & AI Apps: Log Tempo Timesheets for Planning, Project Management & Billing. Plugin Office365, Google & Slack

Go to marketplace

Agile at Scale Software

Agile at Scale

Adapt to changing business needs, rapidly adjust plans, and reallocate investment.

Learn more

Custom charts and dashboards for Jira

Custom Charts for Jira

See how work is progressing and where blockers are with the most flexible reporting app in Jira.

Learn more

Industry-leading project plan and roadmap visualizations with a Gantt chart extension

Gantt Charts for Structure PPM

Visualize project plans and roadmaps with a Gantt chart extension for Jira

Learn more

Monitor financial health at every level

Financial Manager for Timesheets

Monitor projects and portfolios to get simple, clear, and real-time views of your costs, budgets, and profits that can be shared throughout your entire organization.

Learn more

For planning leaders looking to add a big-picture roadmap view to their structured Jira data, this integration is essential. Improve visibility to leadership, reduce reporting admin, and keep your team aligned.

Learn more

Jira Portfolio Management PPM

Structure by Tempo

Jira Project Portfolio Management (PPM): Visualize data and manage projects within spreadsheet-like tables — in less than a minute

Go to marketplace

Jira ITSM Solutions with Tempo

ITSM

Build and scale a custom ITSM solution at your own pace with Tempo's modular suite of integrated tools. Enhance Jira's capabilities and take control of your entire IT portfolio.

Learn more

No-code BigQuery Jira integration

BigQuery Connector for Jira

Integrate Jira with Google BigQuery to seamlessly export and sync data for advanced analytics and customized reporting

Learn more

Never lose track of a brilliant idea again

Idea Manager for Strategic Roadmaps

Never lose a brilliant idea again. Idea Manager for Strategic Roadmaps has built-in best practices to help.

Learn more

No more reporting limitations

Custom Charts for Confluence

Create and share all kinds of highly visual and customizable charts directly on your Confluence pages.

Learn more

Unified time and team management

Integration: Timesheets and Structure

Combining Tempo Timesheets and Structure PPM provides a unified view of time tracking and project progress, enabling more accurate reporting and effective portfolio management. Simplify workflows, enhance collaboration, and ensure projects stay on time and within budget.

Learn more

Align your organization with proactive portfolio management

Portfolio Manager (LiquidPlanner)

Predictive scheduling and the ability to forecast project timelines and spot risks so you can meet deadlines with confidence.

Learn more
Colleagues interacting around a desk

No-Code Power BI Jira Integration

Power BI Connector for Jira

Effortlessly bridge Jira with your preferred BI tool, unlocking unparalleled insights and enhancing decision-making

Learn more

Unified time and team management

Integration: Timesheets and Capacity Planner

Seamlessly manage project timelines and resources while accurately tracking time spent on tasks. This integration enhances visibility, improves planning accuracy, and supports data-driven decision-making for better overall project outcomes.

Learn more

Jira Project Cost Tracking

Financial Manager

Project financial management for Jira & Timesheets. Monitor project costs, expenses, revenue, billing & budgets. Track Capex/Opex

Go to marketplace

Project and program management for Jira

Structure PPM

Visualize all your Jira data & manage portfolios of projects in real-time.

Learn more

Time Tracking Software for Jira

Timesheets

Tempo’s intuitive automation and Jira-native design make it the most trusted time tracking tool for enterprise organization.

Learn more

Roadmapping software for teams of all sizes

Strategic Roadmaps (Roadmunk)

The roadmapping tool designed for high-performing teams delivering boardroom-ready strategic roadmaps.

Learn more

Real-time collaboration and capacity planning in Jira

Capacity Planner

A powerful team resource management tool designed to optimize capacity planning and project management in Jira

Learn more
